How Much Does a Double Storey Extension Cost in 2026?

A two storey extension costs about £72,000 with VAT (£60,000 plus VAT) for a 3m × 4m footprint, which gives you 24m² over two floors. A 4m × 5m footprint, with 40m² over two floors, costs about £108,000 with VAT (£90,000 plus VAT).

Prices on this page include VAT. Builders usually quote before VAT, and building work on an existing home is charged at 20%, so add 20% to a quote marked "+ VAT" before you compare it. You pay about 80% more than for a single storey extension on the same footprint and get twice the floor area, because the foundations and roof are built once and shared by both floors.

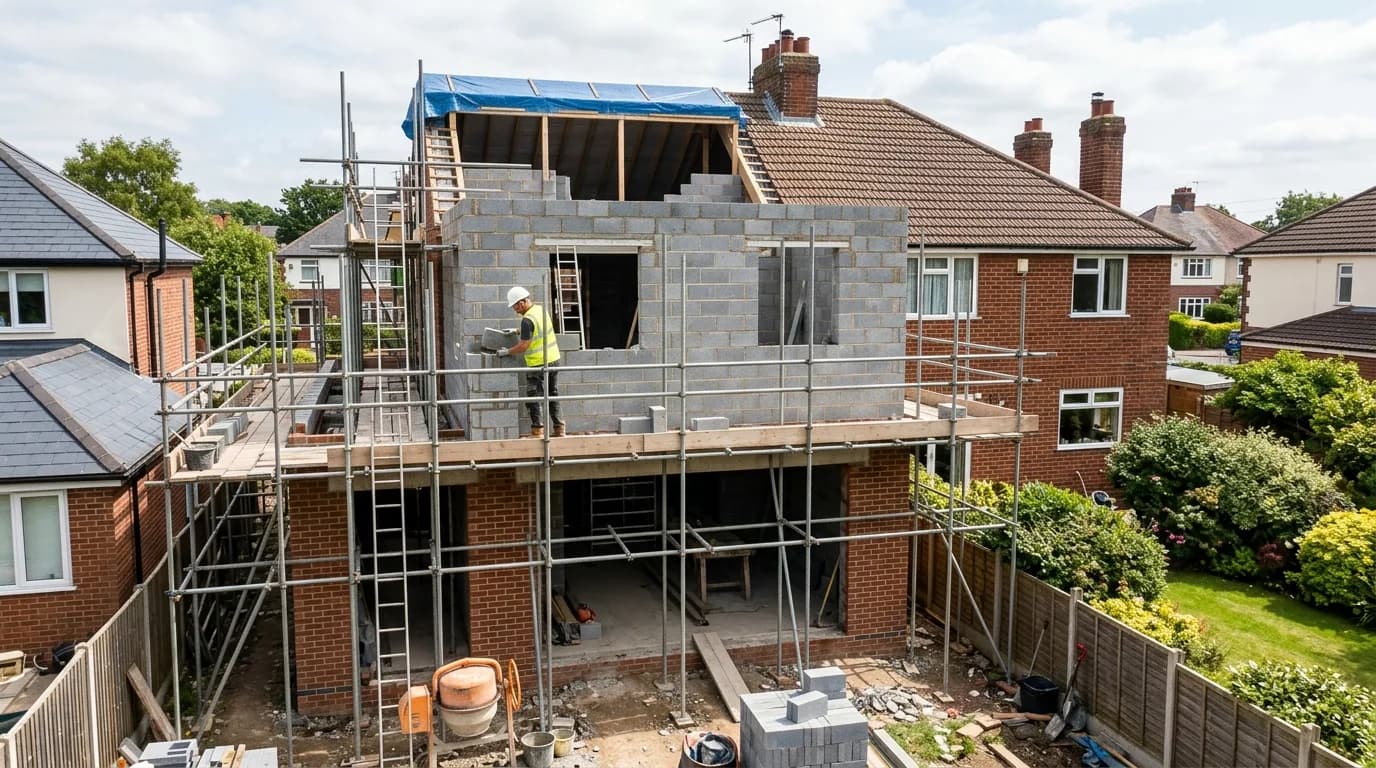

Two storey rear extension under construction on a UK semi-detached house

£72,000

3m × 4m, with VAT

About 80% more

vs single storey

16 to 22 weeks

Build time

Usually needed

Planning

Last updated . Prices are compiled from published trade rate cards, supplier and manufacturer prices, and official fees. How we work out our prices.

To cite this page: Less.co.uk, “Two Storey Extension Cost UK 2026”, updated 23 November 2026, https://less.co.uk/home-improvements/extensions/double-storey-cost. You're welcome to quote these figures with a link to this page.

Double storey extensions usually need planning permission, and they always need Building Regulations approval. A structural engineer is essential for the foundation and steelwork design. Budget for these professional fees from the start.

Two Storey Extension Cost by Size

Prices for a finished extension over both floors: foundations, walls, roof, windows, plastering, electrics and decoration. Each includes VAT, with the before-VAT average underneath. Professional fees, kitchens and bathroom fittings are extra.

Size (footprint = total)Average
Medium (3m × 4m footprint = 24m² total)£72,000£60,000 + VAT
Large (4m × 5m footprint = 40m² total)£108,000£90,000 + VAT
Very large (4m × 7m footprint = 56m² total, rough guide)£150,000£125,000 + VAT

Sources: 2026 per-m² build rates published by UK builders for two storey extensions, and the Planning Portal fee schedule for England. Mid-range spec at UK average rates, shown with and without VAT, excluding professional fees and interior fit-out. Per m² is per square metre of both floors added together. Few firms publish a price for the largest size, so treat that row as a rough guide and get three quotes. How we research our prices.

Get free double storey extension quotes

Tell us about the job and local builders will get in touch with prices. Mention the footprint and whether you have planning permission yet, so everyone prices the same build. Free, with no obligation to book.

Loading your quote form…

Why Double Storey Is Better Value Per m²

The expensive parts of any extension are the bits at the bottom and the top: the foundations and the roof. Whether you build one storey or two, you only dig and pour foundations once, and you only build one roof. The additional cost of a second storey is mainly the extra walls, floor structure, windows, and internal finishes.

In practice, a two storey extension costs about 80% more than single storey for the same footprint (most firms' rates put it at 70% to 100% more), and delivers twice the floor area. So the cost per square metre is usually a little lower, typically about 10% less.

Cost comparison: single vs double (3m × 4m footprint)

ElementSingle storeyDouble storey
FoundationsDug onceDug once, often deeper
WallsOne storeyTwo storeys
RoofBuilt onceBuilt once
ScaffoldingLowerHigher, for longer
Windows and doorsGround floorBoth floors
Total floor area12m²24m²
Typical cost, with VAT£40,000£72,000
Cost per m², with VATAbout £3,300About £3,000
Double storey extension under construction

Planning Permission for Double Storey Extensions

You will usually need planning permission

A 2 storey extension at the back of the house can only go ahead under permitted development if it projects no more than 3 metres beyond the original rear wall and stays at least 7 metres from the boundary behind. The roof pitch has to match the house as far as practicable, and any upper-floor window in a side wall must be obscure glazed and fixed shut below 1.7 metres. Two storey side extensions, and any two storey extension on designated land such as a conservation area, need planning permission. In England a householder application costs £548, rising to £575 for applications made from 8 December 2026, and takes 8 to 10 weeks for a decision.

Neighbour objections are more common

A two-storey extension is more visible and has greater potential to cause overlooking and loss of light. The planning officer will consider the impact on neighbours' amenity. Careful design, such as obscure glazing on upper-floor windows facing neighbours, can address common objections.

Pre-application advice is worth the fee

Most local authorities offer pre-application advice for £100 to £300. This gives you an informal steer on whether your proposal is likely to be approved, and what changes might be needed. Far cheaper than submitting a full application and being refused.

Structural Engineering and Party Wall

Structural engineer: essential, not optional

A double storey extension places significantly more load on foundations than a single storey. The structural engineer designs the foundations (often deeper or wider than single storey), sizes the steel beams where the extension connects to the existing house, and designs the first-floor structure. Expect to pay £800 to £2,000 for structural engineering on a double storey extension.

Foundations need to be right from the start

Double storey extensions typically need deeper foundations than single storey, often 1 metre or more below ground level, depending on soil conditions. If the ground is clay or there are trees nearby, piled foundations may be required, adding £3,000 to £8,000 to the groundworks bill. A soil survey before you start saves money by eliminating guesswork.

Party wall considerations

If your extension is near a boundary, the deeper foundations and greater height make it more likely to trigger Party Wall Act requirements. Serve notices early: at least two months before you want to start on site if you are working on a shared wall, and at least one month for digging foundations near a neighbour. If a neighbour dissents, appointing a party wall surveyor and agreeing an award can take 4 to 8 weeks.

Additional Costs to Budget For

These sit on top of the builder's quote and are easy to overlook when budgeting.

ItemCost
Planning application fee (England), rising to £575 for applications made from 8 December 2026£548
Architect / designer£2,500 to £10,000
Structural engineer£800 to £2,000
Building Regulations application (with VAT)£750 to £1,250
Party wall surveyor if needed (one agreed surveyor; about £2,900 with two)£1,200 to £1,500 per neighbour
Staircase (if not repositioning existing)£1,500 to £4,000
VAT on fees quoted before VAT (20%)Add 20%

Two Storey Extension Prices by Region

What a 3 m by 4 m two storey extension usually costs, with VAT, in each UK region.

Dearest
£84,000London, 17% above the UK average
Cheapest
£64,000the North East and Yorkshire, 11% below the UK average
The gap
£20,000more in London than in the North East and Yorkshire. The South East is next dearest, at £77,000.
RegionWith VATvs UK
London£84,000+17%
South East£77,000+7%
East of England£75,500+5%
North West£73,500+2%
Scotland£72,000UK average
Midlands£71,500-1%
South West£70,000-3%
Wales£67,000-7%
North East£64,000-11%
Yorkshire£64,000-11%

Regional prices use the BCIS location factors published by the Department for Education (December 2025), with the Valuation Office Agency's figure for Wales. There's no current official figure for Scotland, so we show the UK price there. How we work out regional prices.

How to Get Your Double Storey Extension for Less

Double storey extensions are large projects with plenty of scope to spend wisely.

Get at least three quotes

Get at least three quotes and compare them line by line. Prices for the same job often vary by 20 to 40% between firms. Check each one covers the steelwork, scaffolding, roof and Building Control fees so you are comparing like for like.

Build double instead of coming back later for a second storey

Adding a second storey to an existing single storey extension later is far more expensive, because you may need to demolish the roof, strengthen foundations, and re-scaffold. If there is any chance you will want the extra space in the next 5 to 10 years, build double from the start.

Finish the first floor to a basic standard initially

Get the builder to complete the shell and first fix on the upper floor, but hold off on the premium finishes. A plastered, carpeted bedroom costs much less to finish than a fully fitted bathroom or home office. You can upgrade finishes later when budget allows.

Engage a planning consultant before submitting

A pre-application consultation with your local planning department (typically £100 to £300) gives you early feedback on what is likely to be approved. This is far cheaper than a refused application, redesign, and resubmission. Some planning consultants offer this as part of their service.

Serve party wall notices the moment you have drawings

Party wall delays are one of the most common reasons double storey extensions overrun. You cannot start work until the party wall process is resolved. Serve notices as soon as your architect has drawings, and do not wait until you have planning permission.

Compare free double storey extension quotes

Free, with no obligation to book.

Useful resources

What to Expect: The Double Storey Extension Process

A two-storey extension is a major build that typically takes 16 to 22 weeks on site. Here's how the project normally progresses.

  1. 1

    Architectural design and approvals

    An architect or architectural technician prepares the drawings, and a structural engineer provides the calculations. Planning permission is usually required for a two-storey extension, along with Building Regulations and party wall notices if the work affects a shared wall or involves digging near a neighbour's foundations.

  2. 2

    Foundations

    Deeper, wider foundations are dug to support the extra load of two storeys. A structural engineer specifies the foundation depth based on ground conditions and proximity to trees or drains.

  3. 3

    Ground floor walls and first floor structure

    Cavity walls are built to first-floor level. Steel beams and floor joists are installed to form the first-floor platform, then boarded over ready for the upper storey.

  4. 4

    Upper storey walls and roof

    Second-storey walls are built and tied into the existing house. The roof structure, whether pitched or flat, is constructed, tiled, and flashed to the main house.

  5. 5

    Structural opening and steelwork

    A structural steel beam (RSJ) is installed at each level to create the openings between the existing house and the new extension. Building Control inspects the steelwork before it is boxed in.

  6. 6

    Internal fit-out and sign-off

    First fix (electrics, plumbing, heating), insulation, plastering, then second fix (sockets, radiators, skirting, flooring). Building Control issues a completion certificate once all work passes inspection.

Frequently Asked Questions

How much does a two storey extension cost in 2026?

A two storey extension costs about £72,000 with VAT (£60,000 plus VAT) for a 3m × 4m footprint, which gives you 24m² over two floors. A 4m × 5m footprint, with 40m² of new floor, costs about £108,000 with VAT (£90,000 plus VAT), and a large 4m × 7m one about £150,000 with VAT (£125,000 plus VAT). That is about 80% more than a single storey extension on the same footprint, because the foundations and roof are built once and shared by both floors.

Do I need planning permission for a double storey extension?

Usually, yes. A two storey rear extension only counts as permitted development if it goes no more than 3 metres beyond the original rear wall, stays at least 7 metres from the boundary behind the house, matches the existing roof pitch as far as practicable, and has obscure-glazed, non-opening windows in any upper-floor side wall. Two storey side extensions always need planning permission, and so does any two storey extension in a conservation area, National Park or other designated area. In England a householder application costs £548, rising to £575 for applications made from 8 December 2026, and typically takes 8 to 10 weeks for a decision.

Is a double storey extension better value than single storey?

Usually, yes. A two storey extension gives you twice the floor area for roughly 70% to 100% more cost, so it usually works out a little cheaper per square metre than single storey. The foundations, scaffolding and roof are the expensive parts, and adding a second storey on the same foundations is much cheaper than building two separate single storey extensions. If you need both ground-floor space and extra bedrooms, two storey is usually the better investment.

How long does a double storey extension take to build?

A double storey extension typically takes 16 to 22 weeks on site from groundworks to completion. Add 12 to 20 weeks before that for design, planning permission, structural engineering, and Building Regulations approval. The full process from initial design to moving furniture in usually takes 7 to 12 months.

Do I need a structural engineer for a double storey extension?

Yes, always. A structural engineer designs the foundations, calculates beam sizes where walls are removed or openings are formed, and ensures the existing house can take the additional load. The structural calculations form part of the Building Regulations submission. Budget £800 to £2,000 for structural engineering fees on a double storey extension.

Will a double storey extension need a party wall agreement?

You must serve notice under the Party Wall etc. Act 1996 if you dig within 3 metres of a neighbour's building and deeper than its foundations, or within 6 metres where a 45 degree line down from their foundations would be crossed, or if you build on or work to a shared wall. Give at least one month's notice for digging or a new boundary wall, and two months for work to a party wall. Double storey extensions are more likely to need this because their foundations are deeper. If your neighbour consents in writing, no surveyor is needed. If they dissent, expect about £1,200 to £1,500 per neighbour with one agreed surveyor, or roughly £2,200 to £3,700 if each side appoints its own. You normally pay both.
